About the Study

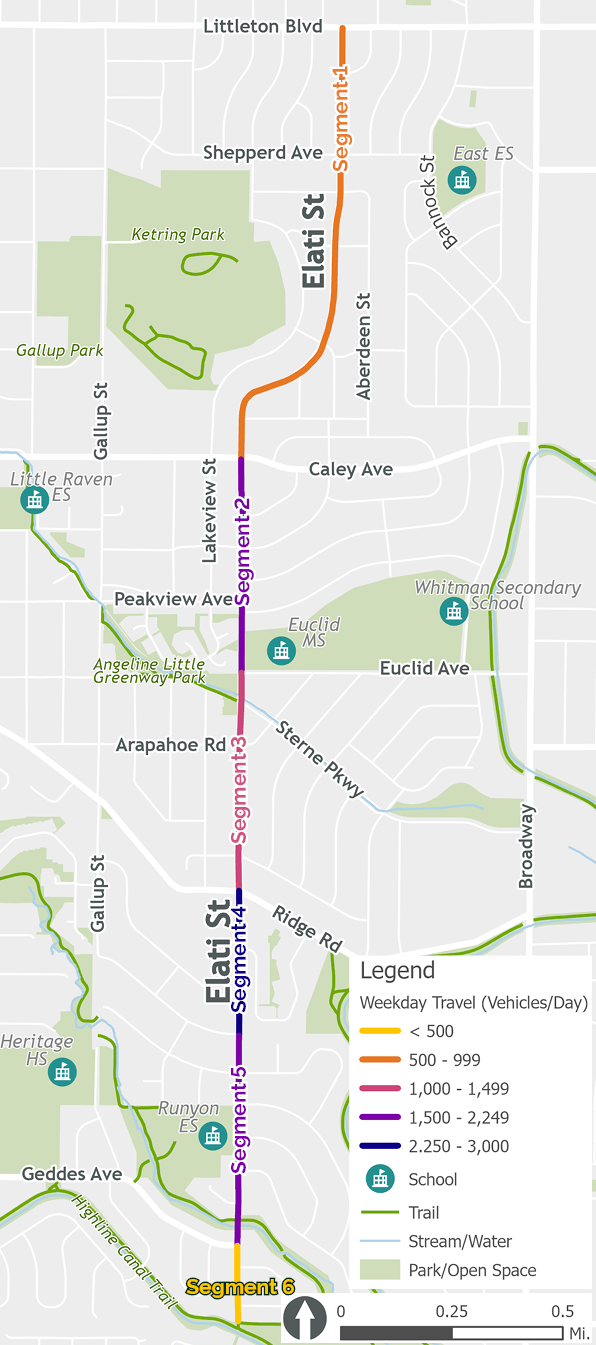

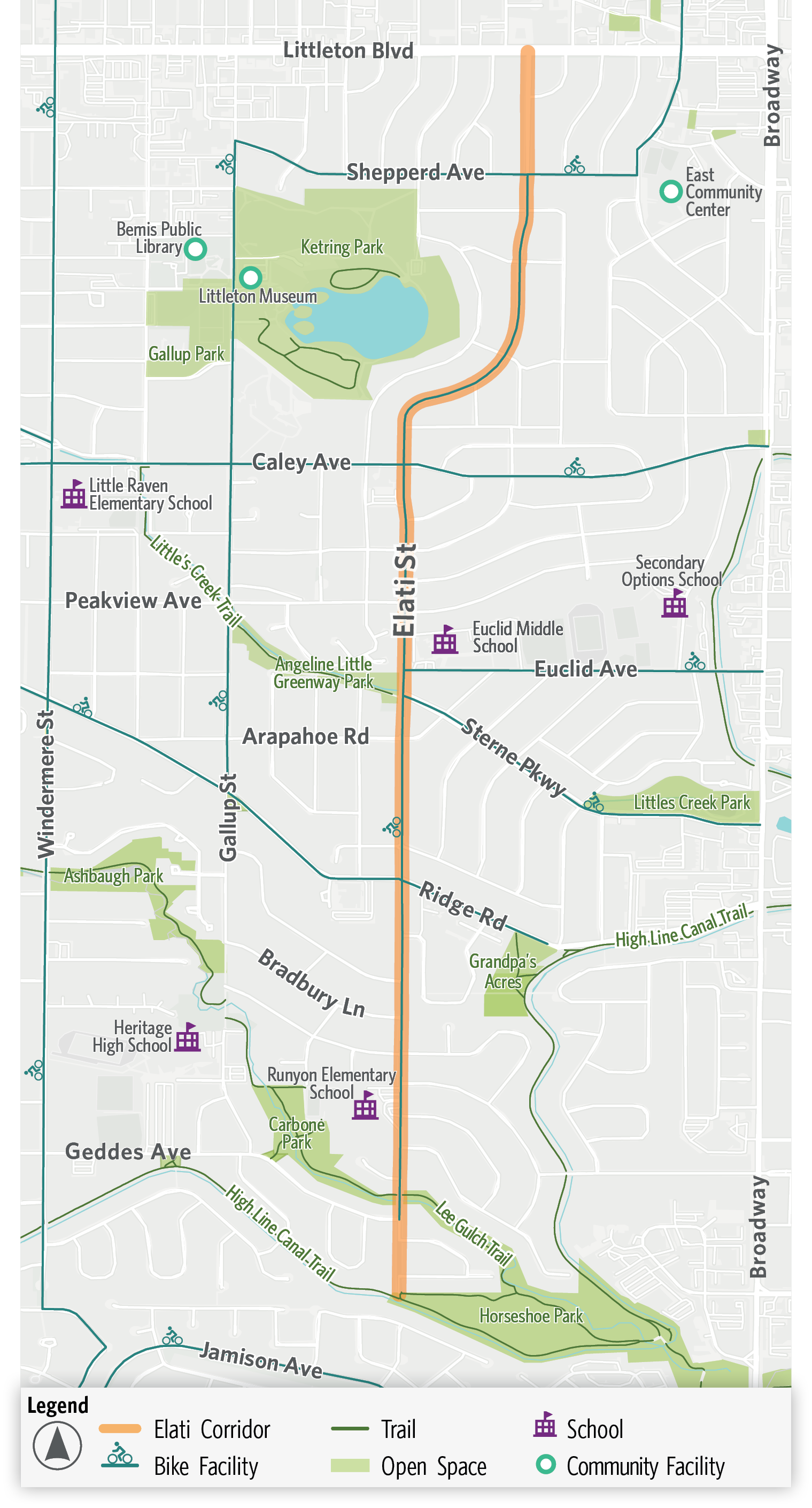

Elati Street is a north-south corridor in Littleton that spans nearly 2.5 miles, from Littleton Boulevard to the High Line Canal Trail. Elati Street is primarily residential with many homes on either side of the corridor and provides access to multiple Littleton Public Schools, multiple trails, parks, and other nearby destinations. The Elati Street Corridor Study will explore strategies to enhance transportation safety along the corridor and at key intersections. It will identify improvements that can be made in the short term, while also considering funding needs for future design and construction projects.
Transportation Master Plan
As part of Littleton’s Safer Streets Program, Elati Street was identified as a priority for safety improvements to enhance the City’s multimodal transportation network. It was also identified in the City's Transportation Master Plan as a Neighborhood Connector and a pedestrian and bike priority street (p. 125-127).
Schedule

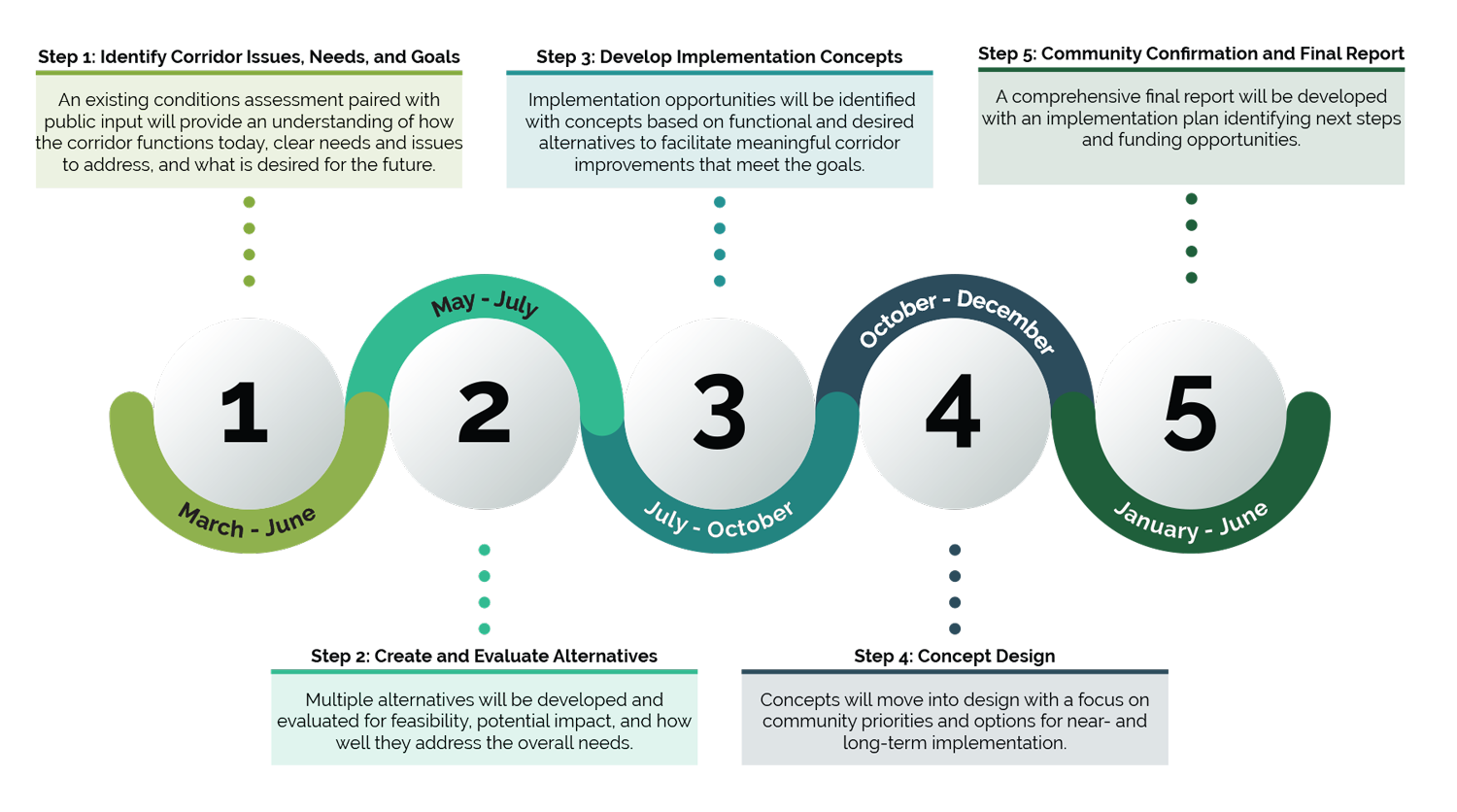

The Elati Street Corridor Study will be conducted throughout 2025 and will extend into 2026 as implementation is explored, including five phases:
What We Heard
Which option should be explored further for implementation opportunities:
Shared Path
44%
Bike Focused
24%
Pedestrian Focused
14%
None of the Options
17%
What tradeoffs would you make?
53% Would like amenities like street trees, landscaping, and lighting along Elati Street
Use of temporary materials: “I do not want temporary solutions”
44% of all respondents
64% of all respondents who live along Elati Street
Prefered Option

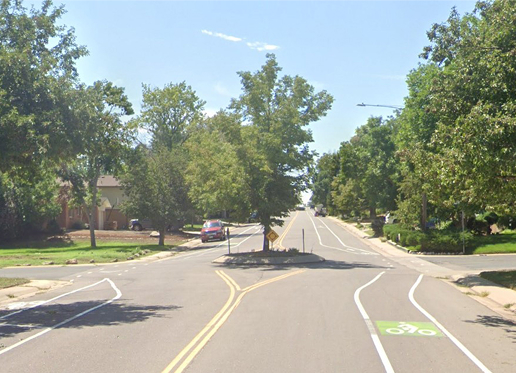

A shared-use path along the corridor to establish a dedicated, protected space for people walking and biking, separate from vehicle traffic.

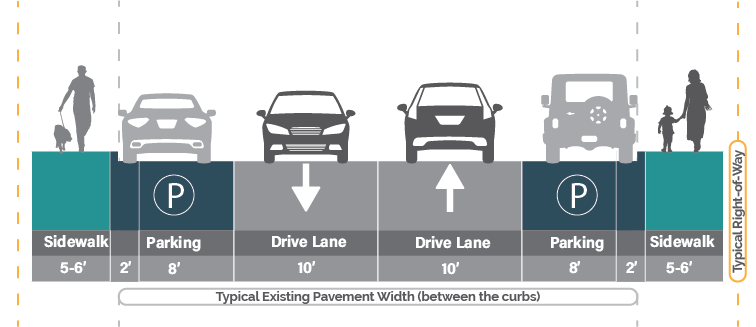

Littleton Blvd to Aberdeen Ave

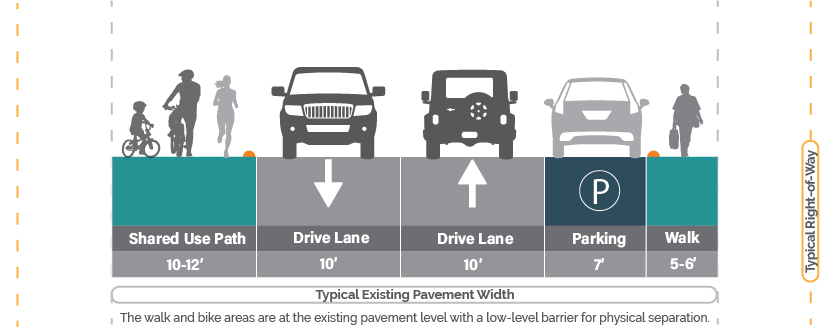

Aberdeen Ave to Caley Ave

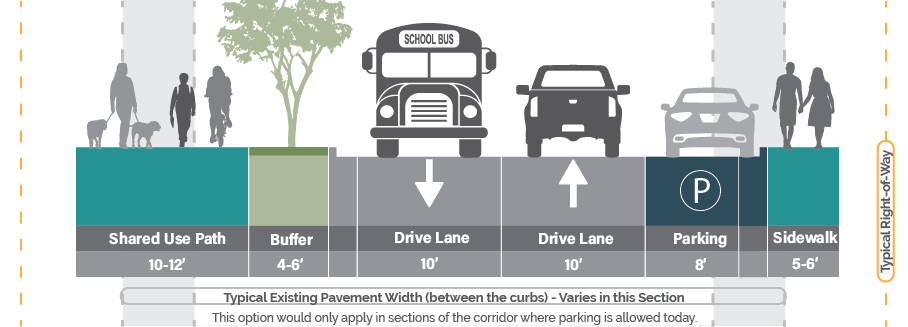

Caley Ave to High Line Canal Trail (With Parking)

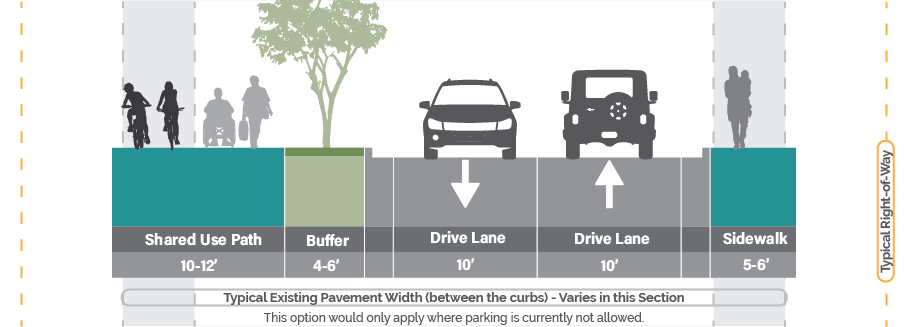

Caley Ave to High Line Canal Trail (If No Parking)
Parking Considerations
The existing right-of-way gives Littleton an opportunity to make impactful improvements. Making the most of that space may mean adjustments to parking in some locations. Here’s how the proposed improvements impact parking along Elati Street.

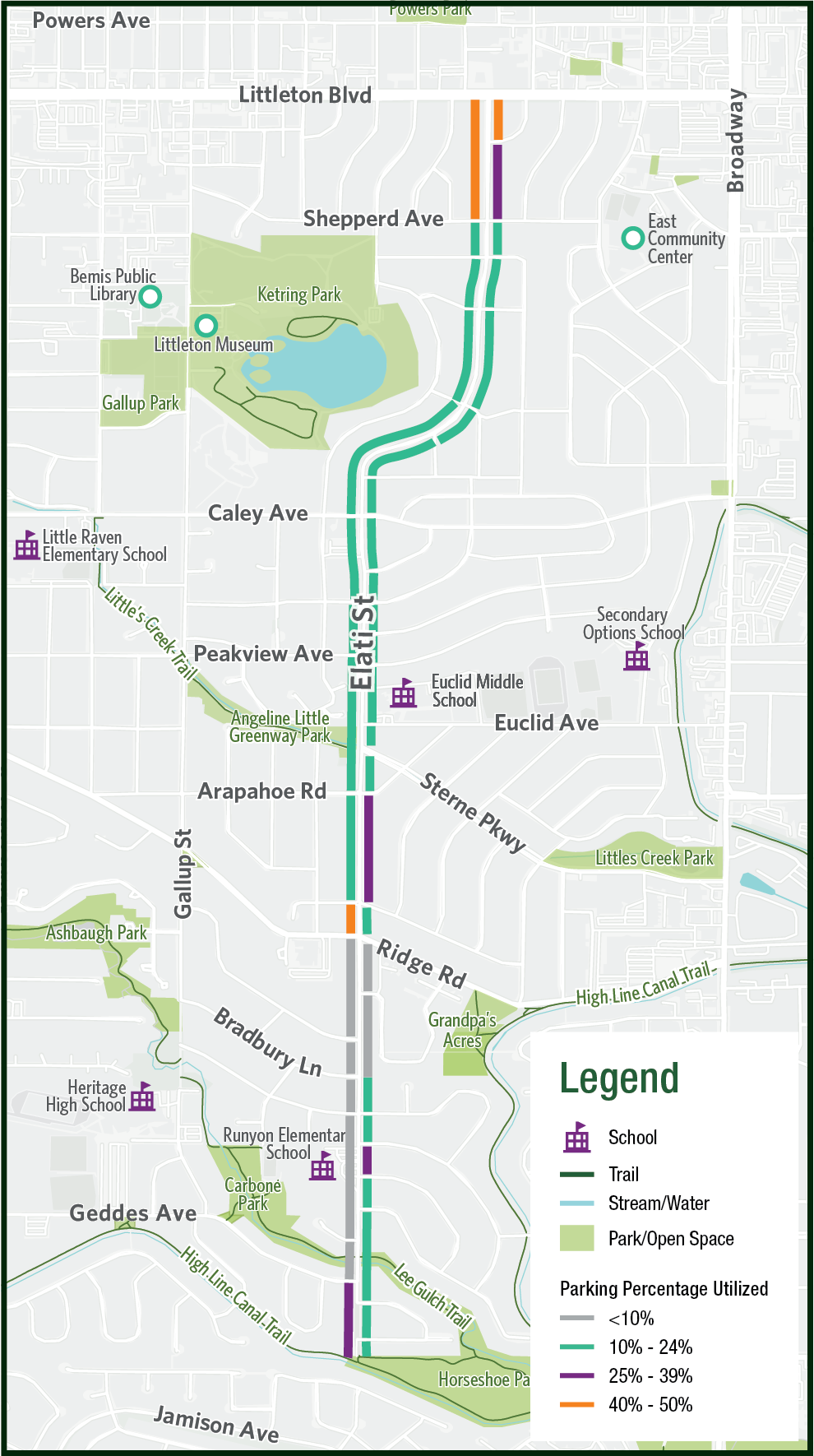

Existing Parking

Parking occupancy did not exceed 40–50% at any time: On average, fewer than 40% of parking spots are occupied along the corridor at any time of day, weekday or weekend. Even the busiest blocks never exceed 50% occupancy.

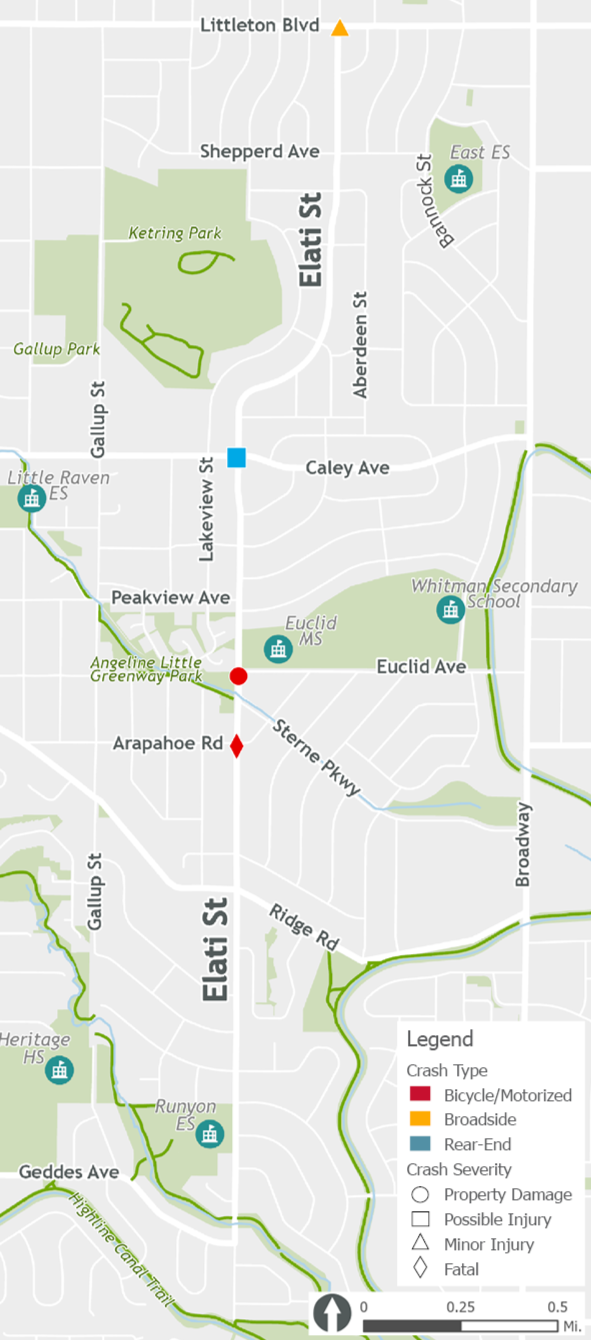

Demand is heavily concentrated in a few locations: between Littleton Boulevard and Shepperd Avenue, south of Arapahoe Road to Ridge Road, and between the Lee Gulch Trail and the High Line Canal Trail. Other portions of the corridor show low utilization.
Parking restrictions vary along the corridor: Parking is currently not allowed between Ridge Road and Bradbury Lane, and along the west side from Bradbury Lane to Geddes.
Implementation Option A
There are three ways Littleton can move forward with implementing improvements on Elati Street, ranging from targeted near-term fixes to a full corridor rebuild. The key tradeoff is how much change to make now versus waiting for a more complete, long-term solution.
Option A: Traffic Calming Only
Option A includes spot treatments focusing on traffic calming and intersection enhancements only. It could proceed in the near-term with available funding.

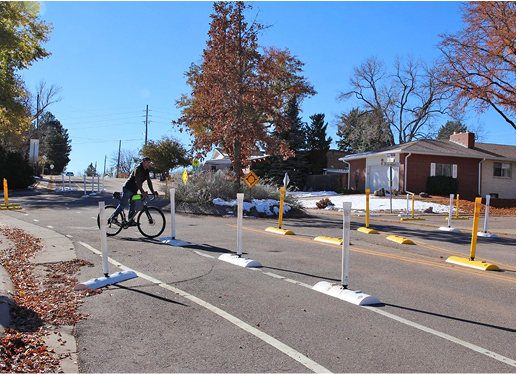

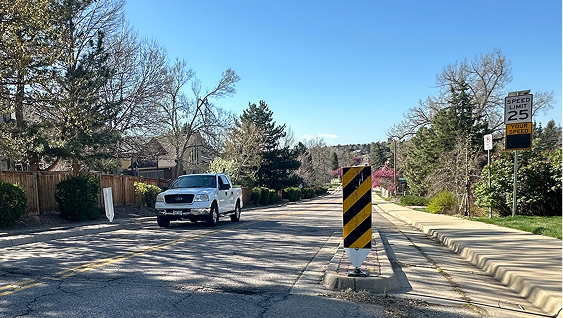

Traffic calming improvements include speed cushions, raised crossings and intersections, Rectangular Rapid Flashing Beacons (RRFBs), narrowing existing street crossings with bulb outs, and potentially replacing traffic circles with standard intersections with bulb outs.
Cost: $$$$
Intersection enhancement and traffic calming materials
Timing: 1–3 years
Can proceed when funding is available and likely occur with an existing pavement project planned for 2028.

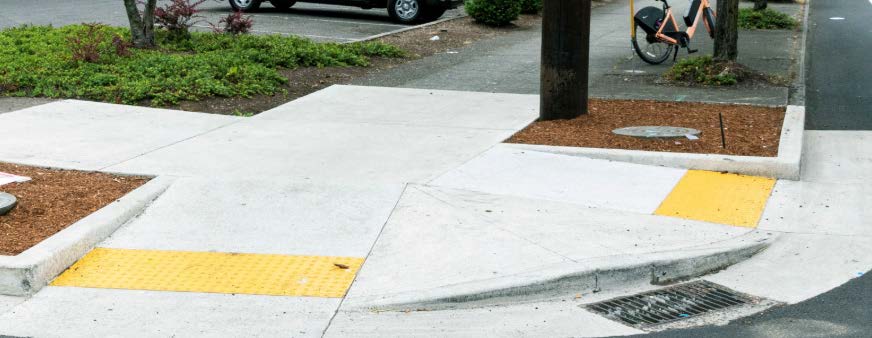

ADA Curb Ramp

Raised Intersection

Rectangular Rapid Flashing Beacon

Speed Cushion
Implementation Option B
There are three ways Littleton can move forward with implementing improvements on Elati Street, ranging from targeted near-term fixes to a full corridor rebuild. The key tradeoff is how much change to make now versus waiting for a more complete, long-term solution.

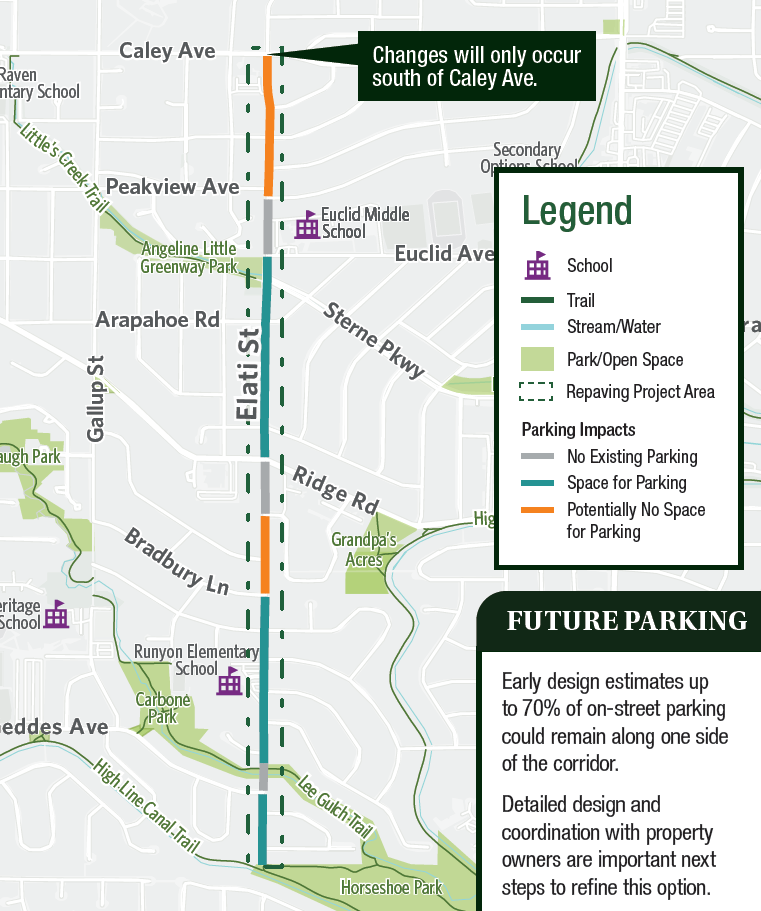

Option B: Traffic Calming + Retrofit
Timing opportunity: A pavement project is already planned for 2028. Option B could be coordinated with that project to reduce cost and disruption

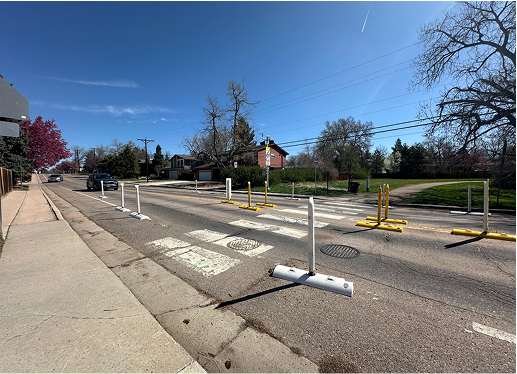

Restriping to add a protected shared community space along the west side of the corridor. Improvements also include traffic calming elements identified in Option A.
Cost: $$$$
Intersection enhancement and traffic calming materials, restriping, vertical separation material
Timing: 1–3 years
Can coordinate with the 2028 pavement project

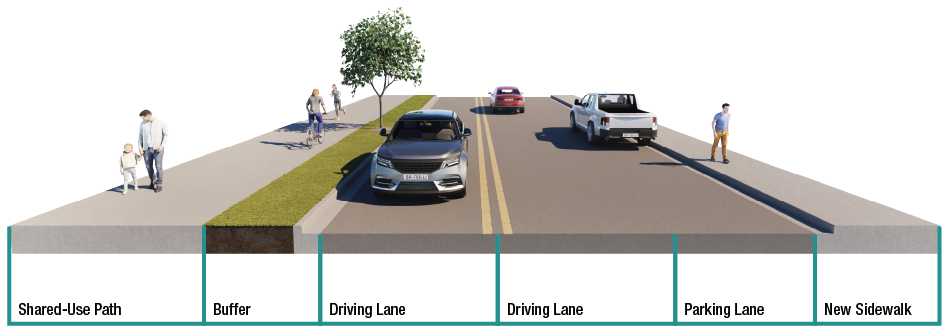

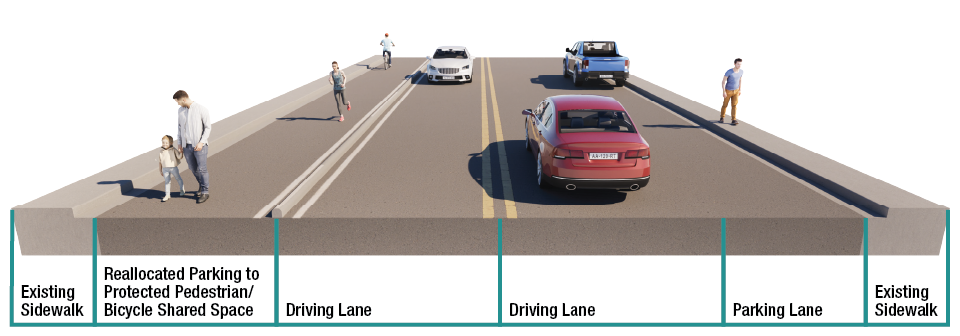

Proposed Cross Section
Future Parking
Implementation Option C
There are three ways Littleton can move forward with implementing improvements on Elati Street, ranging from targeted near-term fixes to a full corridor rebuild. The key tradeoff is how much change to make now versus waiting for a more complete, long-term solution.
Option C: Reconstruct Corridor
Option C would require a rebuild of the corridor and additional funding, resulting in a longer timeline to implement.

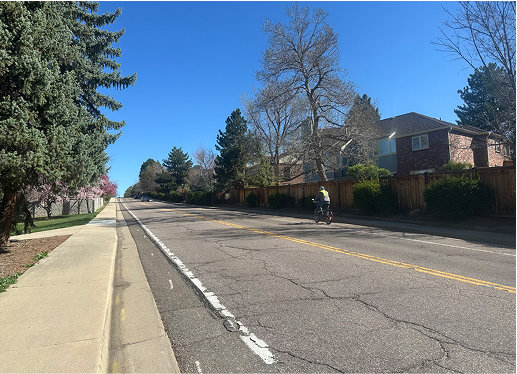

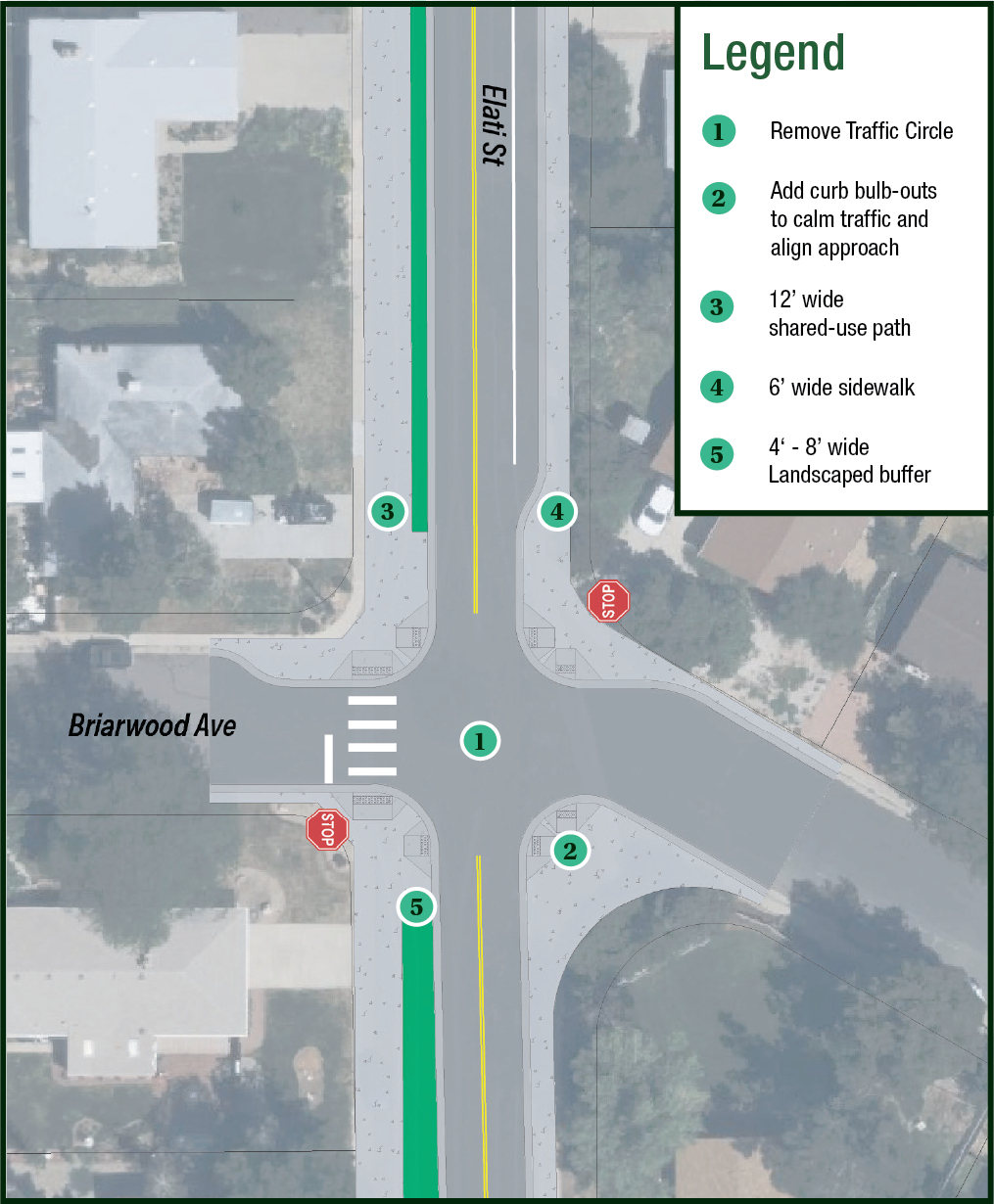

Full rebuild to create a new street design. This includes construction of a shared-use path on the west side with a landscaped buffer, a rebuilt roadway, and a wider east-side sidewalk. Improvements also include traffic calming elements identified in Option A.
Cost: $$$$
Full removal & rebuild
Timing: 10+ Years
Timing is dependent on funding.
